Capacity Expansion · Bandung, Indonesia

33,000 BPH Bottled Water Combi-Block Line in Bandung

A turnkey expansion for lightweight PET bottled water, connecting blow molding, filling and capping with inspection, packaging and palletizing.

Rated Line Capacity
33,000 BPH
Bottle Format
250 mL PET
Neck Finish
29/25
Preform Weight
6.7 g
Finished-Product Pass Rate
90%
Commissioning Test Duration
3 days × 8 hours
33,000 BPH Bottled Water Combi-Block Line in Bandung Running

Project Line Flow

Equipment Used in This Production Line

Product: bottled water · Container: 250 mL PET bottle Select a stage to view the related equipment or inspection details.

Swipe or scroll to explore all stages →

Equipment links describe relevant equipment families. This case describes the installed project configuration.

Running Video

Watch the line during commissioning

The original site footage shows bottle transfer and downstream packaging during testing and commissioning in Bandung.

01 · Expansion Decision

Why did the customer choose another Combi-Block?

The customer already operated a Combi-Block at this factory. When it expanded production, it chose another integrated system based on that experience and its focus on cost per bottle at higher volumes.

The new line was configured for the customer's lightweight 250 mL PET bottle with a short 29/25 neck finish and a 6.7 g preform. The customer considered this format a fit for high-speed Combi production. In the Combi-Block, one unit blows the bottle, fills it with water and applies the cap.

02 · Blow Molding Trials

How was the Combi-Block tuned for lightweight PET bottles?

During commissioning, the team tested preform heating and the stretch ratio. The temperature around the preform support ring was one of the most important settings for this bottle.

  1. 01

    Temperature too high

    Preforms jammed at the machine infeed.

  2. 02

    Temperature too low

    The bottle base turned white after blowing.

  3. 03

    Repeat the blow trials

    The team repeated the trials until preforms moved smoothly into the machine and the bottle base formed correctly.

03 · Line Coordination

How did the downstream line keep pace?

The conveyor layout and dynamic accumulation help coordinate bottle flow between the Combi-Block, inspection, OPP labeling, shrink wrapping and palletizing.

Buffer temporary speed differences

When connected machines briefly run at different rates, the accumulation table gives bottles somewhere to wait. The downstream machines can then take the accumulated bottles as the flow recovers. Sustained line output still depends on each station running steadily.

Convert bottle flow into pack flow

≈22.9 packs/minEquivalent packaging demand for this 24-bottle pack format at the rated line capacity.

33,000 bottles/hour ÷ 24 bottles/pack ÷ 60 minutes/hour.

04 · Quality Checks

What does the line check before packing?

Each bottle passes a three-in-one check after filling and capping, then a separate label inspection after OPP labeling.

  1. 01

    Code, cap and fill level

    After the Combi-Block, the three-in-one inspector checks the printed code, cap and fill level.

  2. 02

    Dry the bottle and apply the label

    Air drying prepares the bottle surface for the OPP label. This step sits between the two inspections.

  3. 03

    Inspect the applied label

    A separate inspection checks the applied label before the bottle enters shrink wrapping.

05 · Commissioning Test

How was the finished-product pass rate measured?

The test ran for 8 hours a day over 3 days on this installed line.

90%Finished-Product Pass Rate

Calculation

Divide the number of bottles accepted at the palletizer exit by the total number of bottles actually produced during the test, then express the result as a percentage.

The result measures finished-product acceptance during that test. The line’s rated capacity for this bottle format is 33,000 BPH.

Delivery Scope

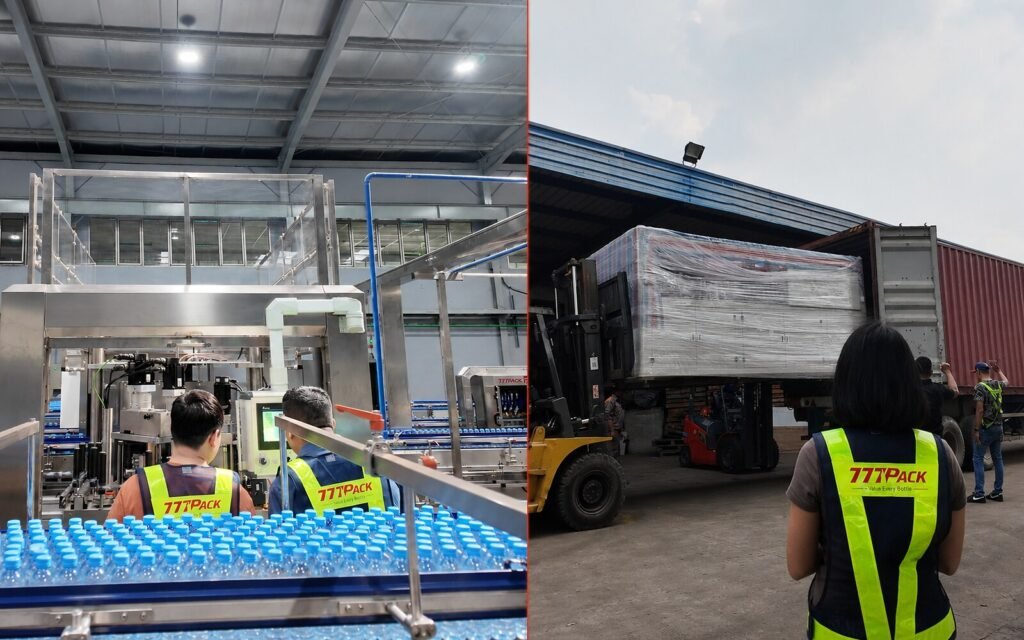

What 777Pack delivered.

Integrated project covering line configuration, equipment integration, inspection, labeling, secondary packaging, conveying and palletizing, with site installation and commissioning support. Explore the bottled water production line solution.

Solution Design
Line Integration
Quality Control
Shipping
Customs / Local Transfer
Installation

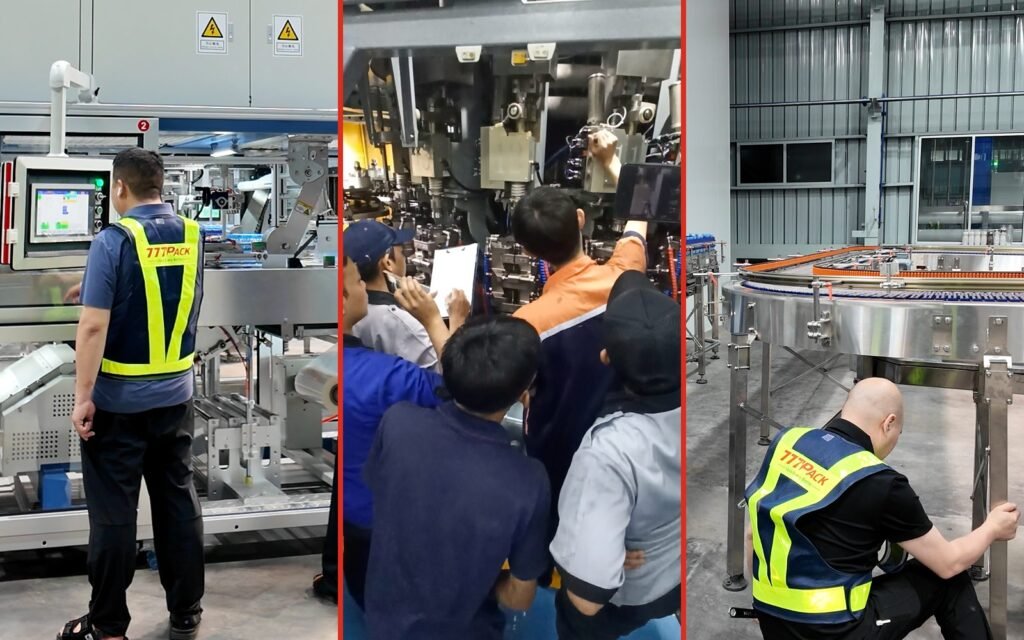

Training
After-Sales Service

Site Photographs

Installation and line setup in Bandung

Technicians checking the bottle-transfer and labeling section on the Bandung bottled water line.
On-site adjustment of a conveyor frame beside the packaging line in Bandung.
Two people reviewing the film-wrapping machine controls on site in Bandung.
The installation team working around the rotary bottle-transfer assembly inside the combi-block.
A laser level and lifting jack used during machine alignment beside the combi-block.
Two workers carrying out stainless-steel pipe welding during the site installation.
